MPR vs CEE

Data

  • We carry out our estimates using the dataset of MPR grant applications produced by the National Agency for Housing (ANAH).

  • This dataset includes all MPR applications starting from the introduction of the programme in 2020, with the exception of larger-scale renovations (gestes d’ampleur) for lower-income households and improvements in copropriétés1.

    • Approx. 500,000 observations (2020-2022), across all improvement types and household income levels2.
  • Note that the relationship to the application processing system for MPR means that our dataset covers all MPR applications, and all house renovations which benefited from MPR grants ; however, all improvements for which MPR was not sought thus remain outside of the scope of our dataset. In other words, we study only a small subset of all energy efficiency renovations carried out in France.

  • We focus on improvements carried out by the lowest income category of households, as these receive the highest amount of MPR subsidy and have the most generous ceiling in terms of overall support received as a percentage of the price of the works (90%). Furthermore, we only study those investments which have benefited from both MPR and CEE support.

The dataset provides information on the overall application, as support can be requsted for multiple improvements within one application, and some characteristics of the applicant. For each individual improvement, we obtain the price as well as the amount of MPR, CEE, and any other subisidies received by the applicant3.

  • The dataset contains variables relating to the MPR grant application procedure, but relatively little information on the applicant, the house being renovated, or the characteristics of the improvement itself, i.e. potential control variables. We use the fiscal reference revenue of the household as a control variable ; a summary of available variables is included in the annex.

  • Some extreme values for prices are present in the dataset, likely attributable to errors in filling out the applications. As a result, prior to aggregation, we remove from the data all observations with prices above the 999th quantile of the improvement type’s distribution4.

  • We limit the scope of our study to that of Metropolitan France, thus excluding from our sample 20 Employment Zones (out of 305 total).

Code snippet for aggregating & cleaning the dataset
# Checking for outliers in prices
# The cutoff at Q999 is ad hoc, so to be refined (also winsorising rather than trimming the sample..)
# The obs > Q999 are filtered out when aggregating into a panel dataset

# mtttcplanfinsolde = Prix TTC du geste renseigné par le demandeur MPR
# subtype = type de geste (PAC, chauffe-eau solaire, chaudière à granulés etc)
# hometype = type de ménage par catégorie revenus (très modestes, modestes, etc)

price_quantiles <- mpr_data[date < "2022-07-15"& date >= "2021-01-01" ] %>%
  group_by(subtype,hometype) %>%
  summarise(q01= quantile(mtttcplanfinsolde, 0.001),
            q1= quantile(mtttcplanfinsolde, 0.01),
            q10= quantile(mtttcplanfinsolde, 0.1),
            q25  = quantile(mtttcplanfinsolde, 0.25),
            q50 = quantile(mtttcplanfinsolde, 0.5),
            q9 = quantile(mtttcplanfinsolde, 0.9),
            q95 = quantile(mtttcplanfinsolde, 0.95),
            q99 = quantile(mtttcplanfinsolde, 0.99),
            q999 = quantile(mtttcplanfinsolde, 0.999),
            max = max(mtttcplanfinsolde)) %>%
  arrange(hometype,subtype)

mpr_monthly <- mpr_data %>%
  left_join(price_quantiles, by = c("subtype","hometype")) %>%
  filter(!mtttcplanfinsolde > q999 ) %>%
  summarise(across(cols_summarise, ~ mean(as.numeric(.), na.rm=TRUE)),
            rfrsum= median(rfrsum),
            .by = c("rel_month","ZE2020","hometype","subtypename")) %>%
  rename_with(~names_summarised, all_of(cols_summarise))

To carry out our analysis of the effects of increasing MPR, we aggregate the data into a monthly panel dataset, with each observation unit consisting of a employment zone (EZ)-improvement type pair.

The outcome variables are thus the averages of the CEE subsidy, price charged for the improvement, and the out-of-pocket expense left to the household after subtracting both MPR, and CEE. These averages are for each combination of : month ; EZ ; and improvement type.

Methodology

Identification

  • For identification, we leverage a 2022 administrative decision to raise the grants for some types of improvements only for identification. In the context of the Russian invasion of Ukraine and the resultant concerns over energy prices and supply, the increase in MPR was part of a push by the French government to reduce national dependence on imported fossil fuels.

  • The decision was announced on March 16 2022, as part of the unveiling of France’s package in response to the energy crisis sparked by the Russian invasion of Ukraine, and made effective on 15 April 2022 ; the latter is the starting date at which the announced increases are made effective, based on the date at which the application for MPR funding was submitted. All dates referred to in this study will refer to this application submission date.

Defining the treated and control groups

  • We exclude from our sample insulation works and various other subsidised services (e.g. preliminary technical audits), leaving only discrete improvements (for instance, a solar-powered water boiler, or a heat pump)5. We study the response of outcome variables for heat pumps following the increase in their MPR subsidy, with solar-powered and thermodynamic water boilers making up the control group.
Nombre de gestes répertoriés dans la base MPR
Période de 5 mois avant l'augmentation du forfait MPR (15/04/2022)
Geste Pré-intervention Post-intervention
Groupe de Contrôle
Chauffe-eau solaire 9764 12407
Chauffe-eau thermodynamique 3245 5983
Groupe Traité
PAC air/eau 13222 24027

Estimation

We use Callaway and Sant’anna’ (2021)’s doubly robust estimation method, as implemented by the R package did. As mentionned in the previous section, units are defined at the combination of locality and improvement type. The treated group consists of installations of heat pumps ; the treatment is binary, corresponding to whether the MPR subsidies were increased on April 15 2022, and is thus also non-staggered. We control for the median fiscal reference revenue. The estimated model can be rewritten as a classic TWFE regression :

\[Y_{i,t}=\alpha_i + \lambda_t + \sum_{k = -12; }^{12} \gamma_k*D_{i,t-k} + \beta*X_{i,t}+\varepsilon_{i,t}\] With \(Y_{i,t}\) the average at the level of \(i,\) the ZE and improvement type combination. Units are weighted according to the share of the national population.

Results

CEE

Code for did estimation of CEE effects
did_pcae_tmo_cee<- att_gt(data= mpr_monthly %>%
                            filter(subtype == "pcae" | subtype %in% c(subtypes_control_exventil) ) %>%
                            filter(hometype=="TMO")%>%
                            filter(rel_month > -12 & rel_month < 13),
                          yname = "cee",
                          tname = "period",
                          idname = "zegeste", # unit = ZE x Geste
                          gname = "treated_month",
                          allow_unbalanced_panel = TRUE,
                          xformla = ~rfrsum, #revenu fiscal de référence tel que déclaré
                          weightsname = "popweight",
                          base_period = "universal")
  • Figure 1 shows the estimated effects of the MPR increase on average CEE funding received, which decreased by around 300 euros for the treated improvement type (heat pumps) compared to the controls (water boilers).

  • The joint test of significance of the pre-intervention coefficients clearly rejects the null hypothesis of no difference in trends between both groups prior to the MPR increase. Arguably, however, this rejection is driven by a difference in trends which appears to be insignificant starting from 3 periods (6 months from t=0) before the shock.

    • Peut-être un lien avec la fin de période CEE ? Le coefficient à t = -2 correspond à la période ~15/10-11/2021 [mais pourquoi la fin de période CEE affecterait de manière différenciée les PAC et les chauffe-eau ?].
    • The HonestDID analysis shows that assuming the deviation in trends from t=-5 to t=-2 persisted over the entire sample, the estimated CEE response cannot be attributed to the MPR increase6.

[Les résultats pour le CEE sont au pas de 60j pour l’instant - a priori on va rester sur 30j ?]

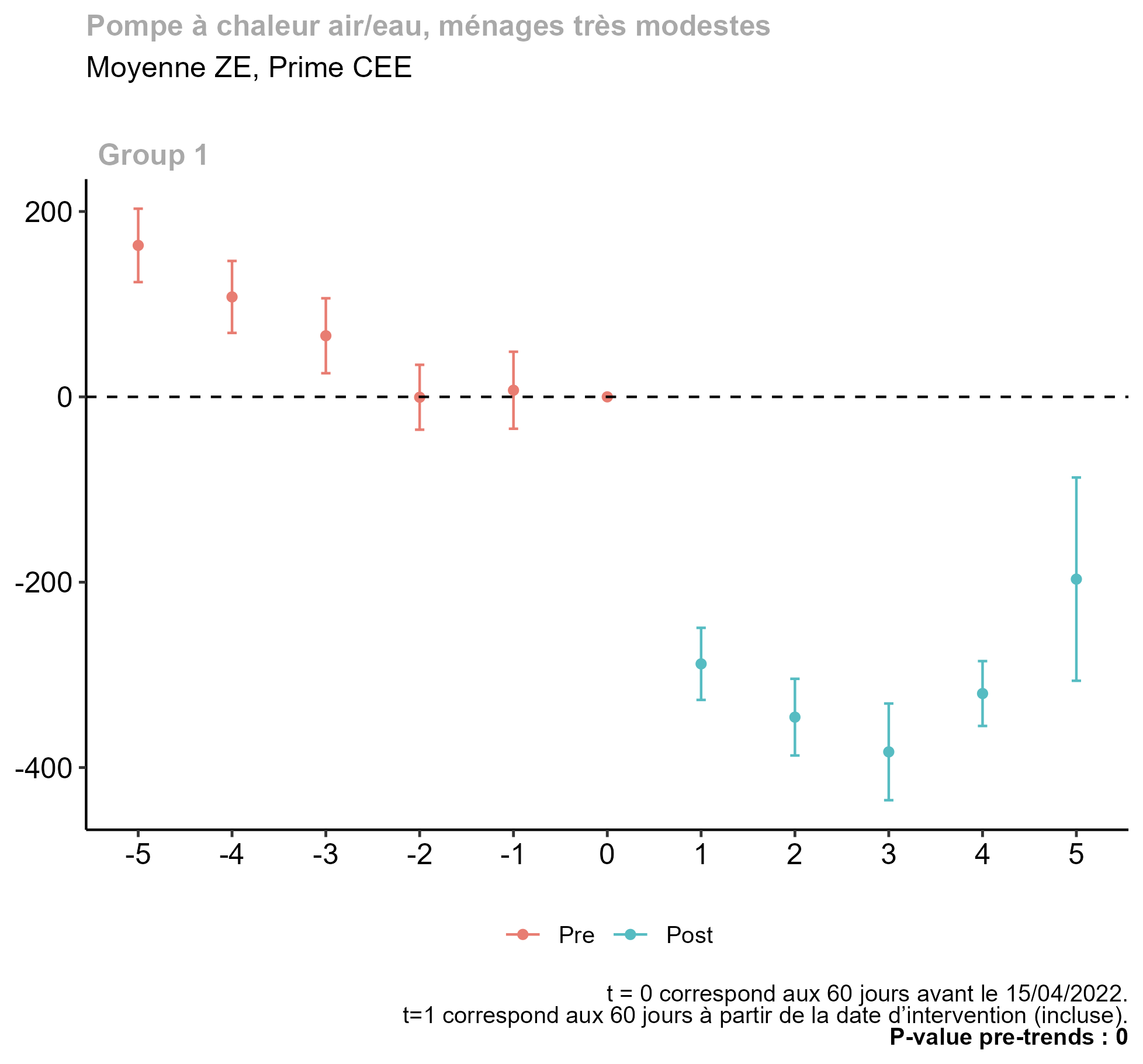

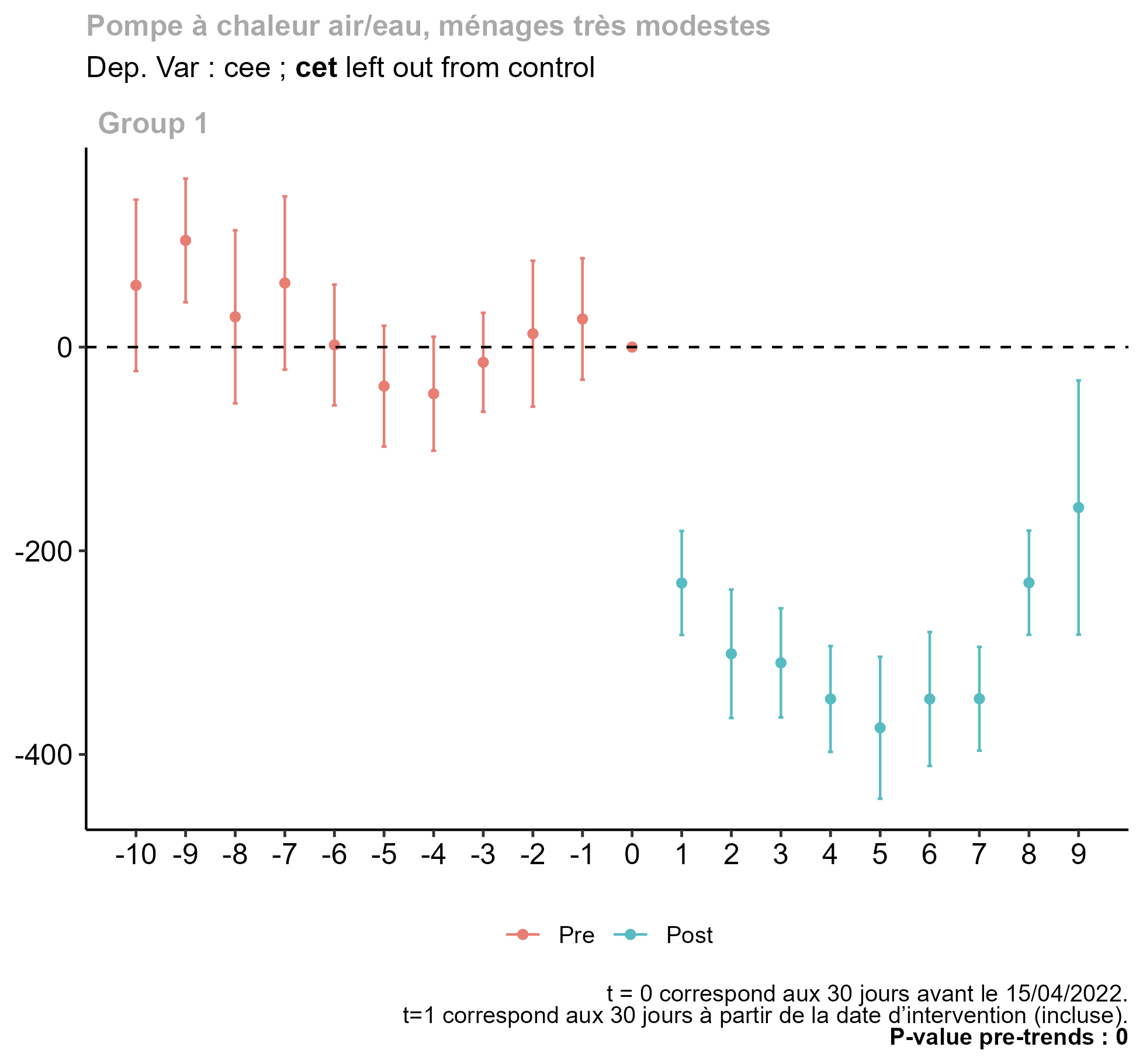

Figure 1: Estimated effects on CEE grants.

We use the HonestDID package to assess the sensitivity of the estimated response of CEE to deviations from parallel pre-trends. - We examine the estimated response at t=3 (mid-August to mid-October 2022).

Specification for HDID analysis of estimated CEE effects
aggte_ceebimonthly = aggte(
  did_pcae_tmo_cee_bimonth,
  type = "dynamic"
)

hdid_cee_agg_RM = honest_did(aggte_ceebimonthly,
                          type="relative_magnitude",
                          e = 3,
                          Mbarvec=seq(from = 0.5, to = 2, by = 0.5))

hdid_cee_agg_SD = honest_did(aggte_ceebimonthly,
                          type="smoothness",
                          bias ="negative",
                          monotonicity = "decreasing",
                          e = 3)

Figure 2: Estimated effects on CEE grants.

Price of improvements

Code for did estimation of price effects
did_pcae_price <- att_gt(data= mpr_monthly %>%
                               filter(subtype == "pcae" | subtype %in% c(subtypes_control_exventil)) %>%
                               filter(hometype=="TMO")%>%
                               filter(rel_month > -12 & rel_month < 13) %>%
                               filter(!is.na(price)),
                             yname = "price",
                             tname = "period",
                             idname = "zegeste",
                             gname = "treated_month",
                             allow_unbalanced_panel = TRUE,
                             weightsname = "popweight",
                             xformla = ~rfrsum,
                             base_period = "universal") # NB : point estimates and esp SEs are sensitive to risk_seuil control

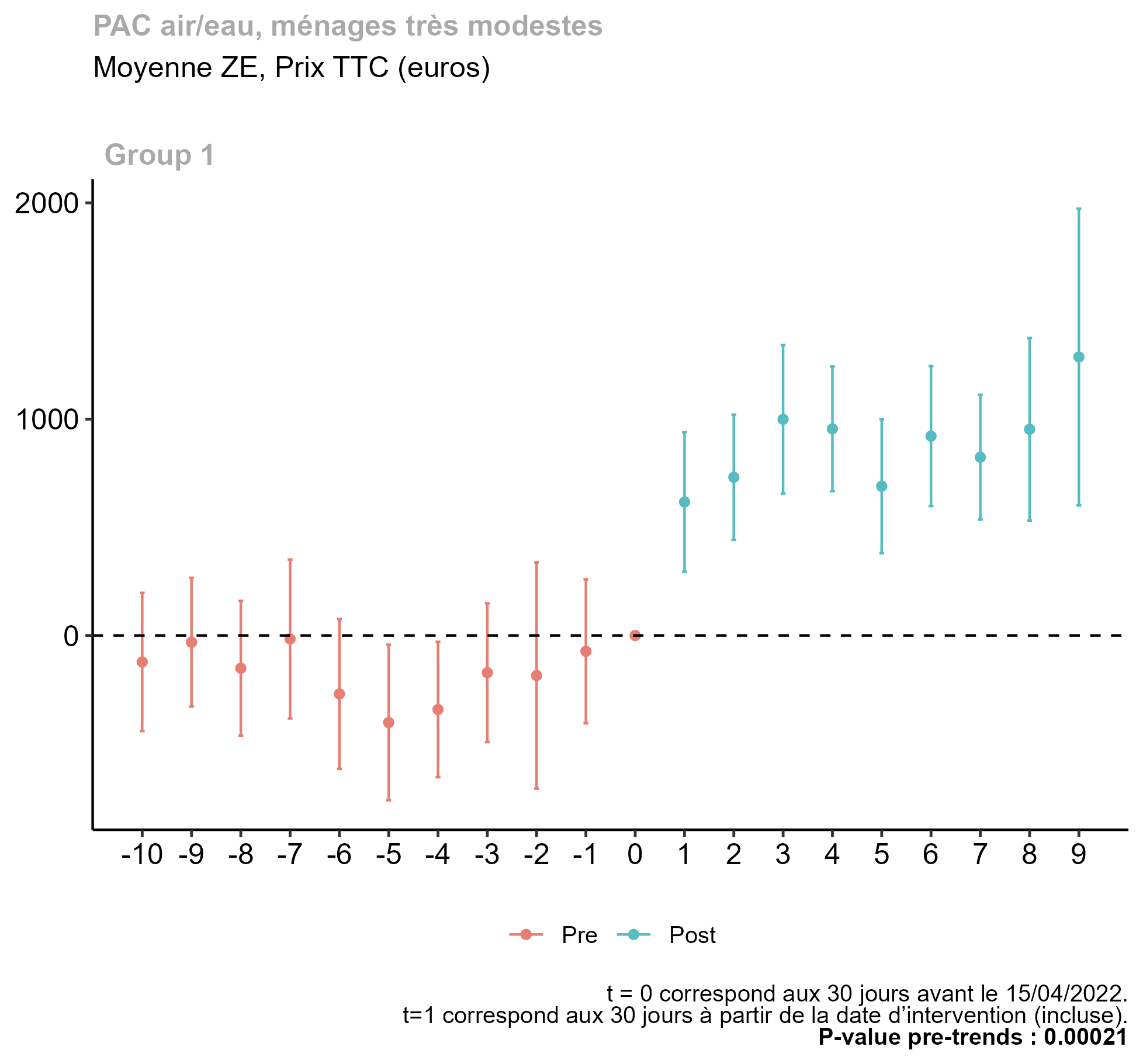

Figure 3: Estimated effects on price of the improvement, heat pumps, low-income households.
  • The MPR increase may have caused an increase in the price of heat pump installations relative, approximately 700 euros7, although the confidence intervals are rather wide.

  • At this stage caution must be exercised in interpreting this estimate :

    • As explained in the Data section, the “price” is the bill faced by the household for the equipment as well as its installation. Our dataset does not include explicit measures of the performance of the equipment, so the apparent price increase may instead reflect that the higher subsidy enabled low-income households to invest in better equipment8.
    • The joint test rejects the null hypothesis of no difference in pre-intervention trends. Although the individual point estimates are rather imprecise, from t = -5 (mid-October 2021) there does appear to be an upwards deviation of the trend in the price of heat pumps relative to that of the control group.
    • The HonestDID analysis shows that the estimated post-intervention coefficients are not robust to the pre-intervention deviations from parallel-trends.
  • A explorer : d’après l’étude de marché des PAC réalisée par Observ’ER et publiée en juillet 2022, sur la fin 2021-début 20229 :

    • La demande est très forte.
    • Problème d’approvisionnements : “Malheureusement les pénuries de composants posent de vrais problèmes à la filière […] Nous partons du principe que la guerre ne va pas durer des années, et peut-être que la Chine va arrêter sa politique de zéro Covid catastrophique pour l’économie. Mais pour l’instant c’est très pénalisant.” et “Nous faisons face à des problèmes d’approvisionnement qui limitent les ventes. S’il y a un tassement du marché, ça sera lié à un problème d’offre, pas de demande.
    • Dépendance aux inputs importés d’Asie, bien qu’une production/assemblage industriel importante a lieu en Europe et en France.
    • Mais à vérifier : l’argument n’est pertinent que si les équipements “contrôle” (chauffe-eau) n’ont pas la même exposition aux chocs sur les chaînes d’approvisionnement post-COVID.

We use the HonestDID package to assess the sensitivity of the estimated response of CEE to deviations from parallel pre-trends.

  • We examine the estimated response at t=4 (mid-August to mid-September 2022)10.
Specification for HDID analysis of estimated price effects
aggte_price = aggte(did_pcae_price,
                    type="dynamic")

hdid_price_SD = honest_did(aggte_price,
                        type = "smoothness",
                        bias= "positive",
                        e=4,
)

hdid_price_RM = honest_did(aggte_price,
                           type="relative_magnitude",
                           Mbarvec=seq(from = 0.5, to = 2, by = 0.5),
                        e=4,
)

Out-of-pocket expenses [traduction de reste à charge ?]

Figure 4: Estimated effects on the out-of-pocket expenses.

Here we show the estimated effect of the MPR increase on the part of the renovation expenses which must be financed by the household themselves (i.e. : the price, minus MPR and CEE financing).

  • Overall, the estimates show the same pre-intervention pattern as in the case of the price variable, i.e. a positive difference in pre-trends starting from October 2021.

Annex

HonestDID

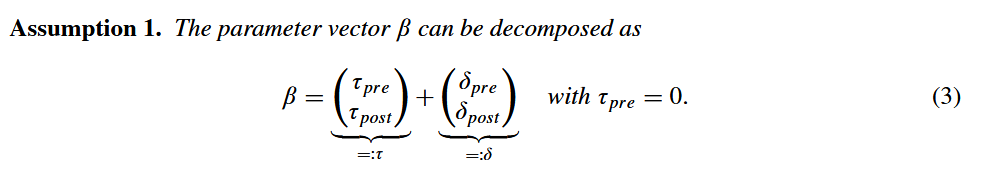

Start from Rambachan, Roth (2023)’s decomposition of the target parameter vector.

Further, define \(\delta_s\) the difference in trends between control and treated groups at horizon \(s\) (when the intervention starts, \(s=0\)).

Target parameters are partially identified by assuming \(\delta\) is in a (user-defined) set of envisaged difference in trends \(\Delta\), with the parallel trend assumption nested as \(\Delta = \{\delta:\delta_{post}=0\}\).

  • The usual approach to parallel trends : check that \(\delta_{pre}=0\) and assume that \(\delta_{post}=\delta_{pre}\).

We use 2 of the default ways of specifying \(\Delta\) suggested by Rambachan, Roth (2023).

Binding relative magnitudes of \(\delta_s\) for consecutive periods (“RM”) :

\[\Delta^{RM}(\bar M) = \{ \delta : \forall t \geq0, | \delta_{t+1}-\delta_t| \leq \bar M * max_{s <0}|\delta_{s+1}-\delta_s| \}\]

- "$\bar M$ bounds the maximum post-treatment violation of parallel trends between ***consecutive*** [our emphasis] periods by  times the maximum pre-treatment violation of parallel trends."

- Authors highlight its relevance in cases where one wants to test whether post-period estimates might be caused by confounding *shocks*, of magnitude comparable to the highest pre-intervention confounding shock^[B: Par défaut les fonctions implémentées dans R choisissent la valeur de $|\delta_s|$ la plus élevée dans la période pre-treatment. Rien n'empêche en théorie de choisir les périodes pre- qu'on juge les plus pertinentes.].

Binding the smoothness of \(\delta_s\) (“SD”) :

If the researcher is interested in binding the changes in the differential trends between control and treated groups :

\[\Delta^{SD}(M) := \{\delta: |(\delta_{t+1} - \delta_{t}) - (\delta_t - \delta_{t-1}) \leq M\}\] A common practice is controlling for group-specific linear trends, i.e. setting \(M=0\).

  • One can further impose sign and monotonicity restrictions, e.g. that the differential trend be increasing and/or be of positive sign.

Robustesse : leave-one-out

Effet CEE :

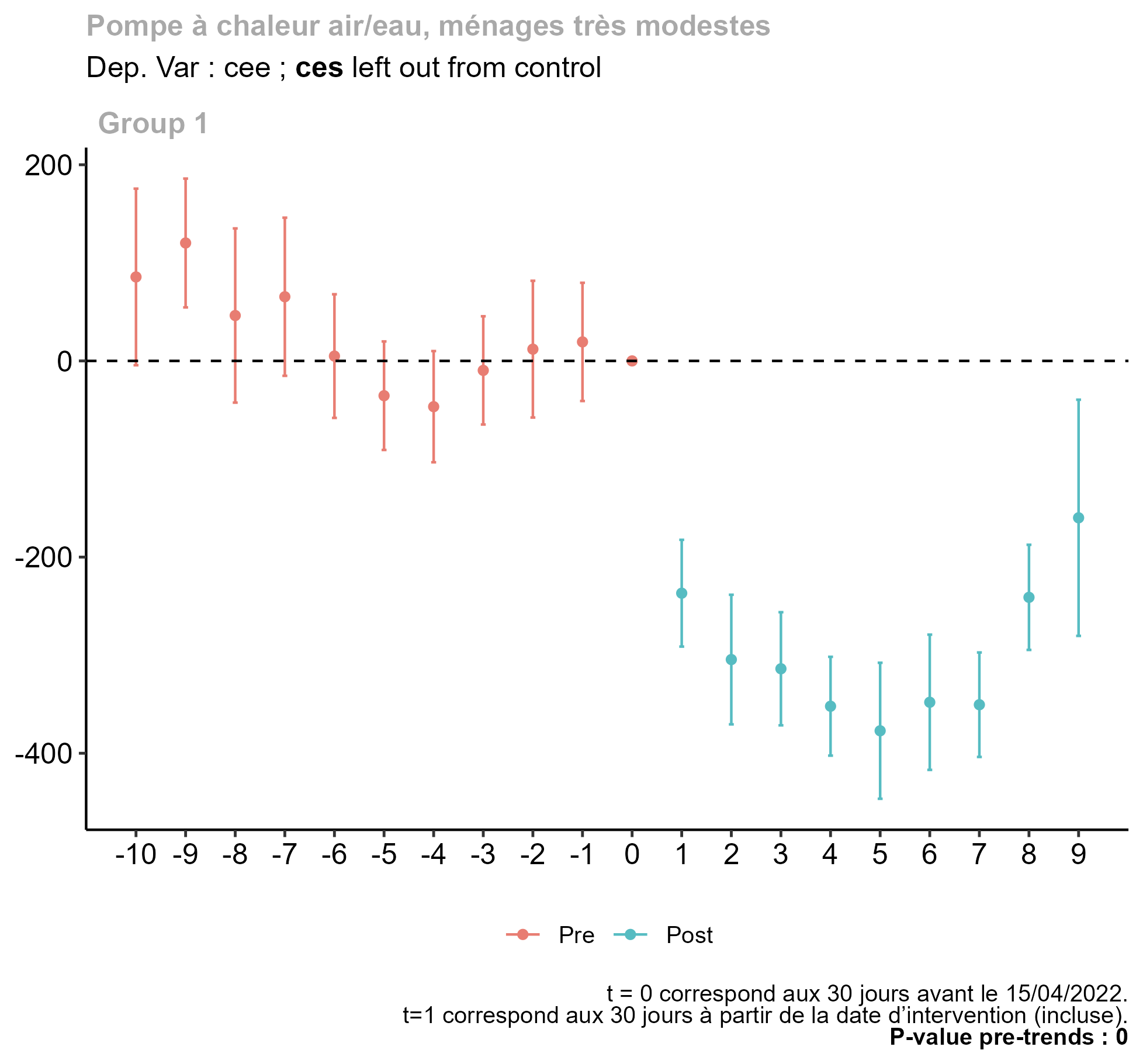

  • En excluant les chauffe-eau thermodynamiques du groupe Contrôle :

  • En excluant les chauffe-eau solaires du groupe Contrôle :

Effet “Prix” :

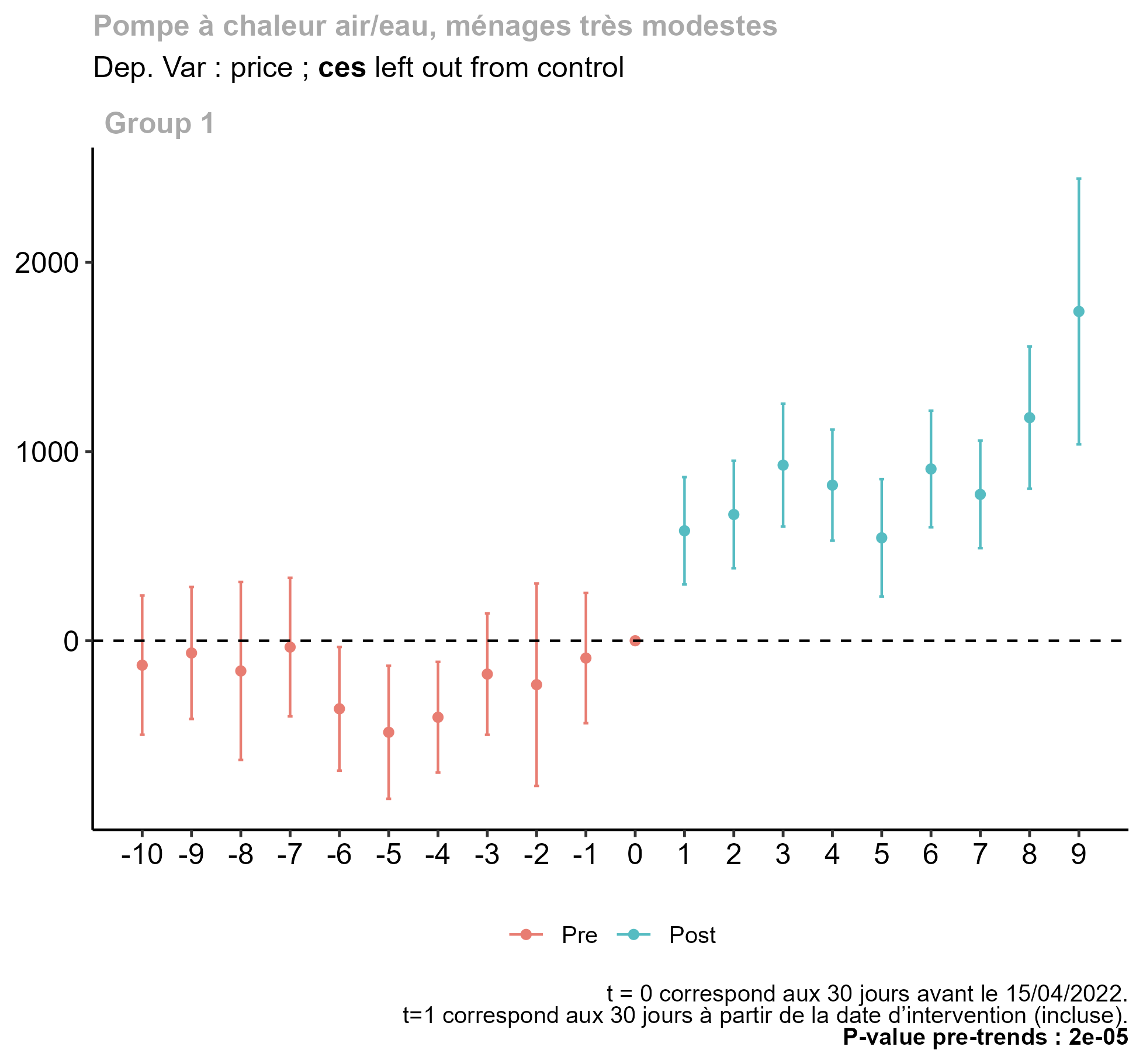

  • En excluant les chauffe-eau thermodynamiques du groupe Contrôle :

  • En excluant les chauffe-eau solaires du groupe Contrôle :

A dip in MPR applications between March and April ?

Footnotes

  1. A venir avec l’ajout de la base CASD correspondante↩︎

  2. B: Nombre exact à vérifier.↩︎

  3. Local governments in particular may have their own schemes supporting energy efficiency improvements ; within our sample, these appear to have been very rarely used.↩︎

  4. B: Il y a probablement une manière plus sophistiquée de faire ça ?↩︎

  5. We focus on heat pumps, which provide the largest sample size, setting aside the analysis for pellet heaters.↩︎

  6. B: Hypothèse très forte ?↩︎

  7. B: A vérifier - ici je prends la moyenne des 5 coefficients estimés en période post-.↩︎

  8. B: Idéalement j’aurai la base CEE fin mars, donc possibilité d’utiliser les KWh cumac des fiches standardisées pour prendre en compte la performance.↩︎

  9. Observ’ER (2022), “Étude qualitative du marché des pompes à chaleur individuelle”, p. 35. Accessible à https://energies-renouvelables.org/wp-content/uploads/2022/09/ObservER-Rapport-Quali-PAC-2022-final-1.pdf .↩︎

  10. B: à harmoniser : le choix de la période sur laquelle faire l’analyse HDID↩︎
